In-Home Senior Care Cost in 2026: Hourly Rates, Monthly Projections, and State-by-State Guide

A comprehensive cost guide for adult children researching in-home care for a parent. Covers the national median hourly rate ($34–$35), monthly costs at different care schedules, full state-by-state data, agency vs. private hire premiums, and annual projections to help families build an accurate budget.

By Editorial TeamUpdated
A middle-aged woman and her older mother sitting at a kitchen table looking at a tablet showing a cost breakdown.
Building an accurate care budget starts with understanding the three variables that determine your actual cost: hourly rate, weekly hours, and location.

The Real Question Families Ask: What Will In-Home Care Actually Cost Us?

You've had the conversation. Maybe it happened after a fall, a hospitalization, or a series of small incidents that made it clear your parent can't manage alone anymore. Now you're facing a question that feels impossible to answer with a simple search: how much is this actually going to cost?

The short answer is that in-home senior care in 2026 costs a national median of $34 to $35 per hour. But that single number is almost useless for budgeting because it hides two massive variables: where you live and how many hours of care you need. The real range runs from about $23 per hour in parts of the South to $44 per hour in the upper Midwest and Pacific Northwest. And the difference between hiring a helper for 7 hours a week versus 44 hours a week is a roughly 3-to-1 swing in monthly cost.

This guide is built for the specific moment you're in: you need to know what care will cost for your parent, in your state, at the schedule your family can manage. We'll walk through the national baseline, the state-by-state breakdown, the difference between hiring through an agency versus directly, and how to turn all of it into a budget you can actually use.

National Median Cost of In-Home Care in 2026: $34–$35 Per Hour

Three major sources converge on a national median hourly rate of $34 to $35 for non-medical in-home care in 2026. CareScout's 2025 Cost of Care Survey (fielded July through November 2025, published early 2026) reports a median of $35 per hour, a 3% increase from $34 in 2024. A Place for Mom's 2026 Costs of Long-Term Care and Senior Living Report puts the national median at $34 per hour. SeniorLiving.org, citing CareScout data, also reports $35 per hour.

This national median is the right starting point for a rough estimate, but it masks enormous geographic variation. The same 30-hour-per-week schedule that costs $4,416 per month at the national median could cost $3,000 in Louisiana or $5,520 in South Dakota. That's why the state-level data in the next section is essential for building a realistic budget.

Monthly Cost by Care Schedule: From Part-Time to Near-Full-Time

The number of hours you need each week is the single biggest lever on total cost. The table below shows monthly costs at four common care schedules using the $34 per hour national median from A Place for Mom. These are the hours that correspond to real caregiving scenarios: a few hours of companionship and light help, daily assistance with meals and medication, a full workday of coverage, and near-continuous care.

Monthly cost estimates for in-home care at different weekly schedules, based on the national median rate of $34/hour. Source: A Place for Mom 2026 Costs of Long-Term Care and Senior Living Report.
Weekly HoursDaily EquivalentTypical ScenarioMonthly Cost ($34/hr)
7 hours1 hour/dayCompanionship, light housekeeping, medication reminders$1,031
15 hours~2 hours/dayMeal prep, bathing assistance, daily check-ins$2,208
30 hours~4.5 hours/dayCoverage during a full workday, help with multiple ADLs$4,416
44 hours~6.5 hours/dayNear-continuous care, significant mobility or dementia support$6,478

The swing from 7 hours per week to 44 hours per week is more than 6x the cost — from roughly $1,000 per month to nearly $6,500. Most families fall somewhere in the middle, needing 15 to 30 hours per week for a parent who needs help with meals, medication management, and personal care but does not require round-the-clock supervision.

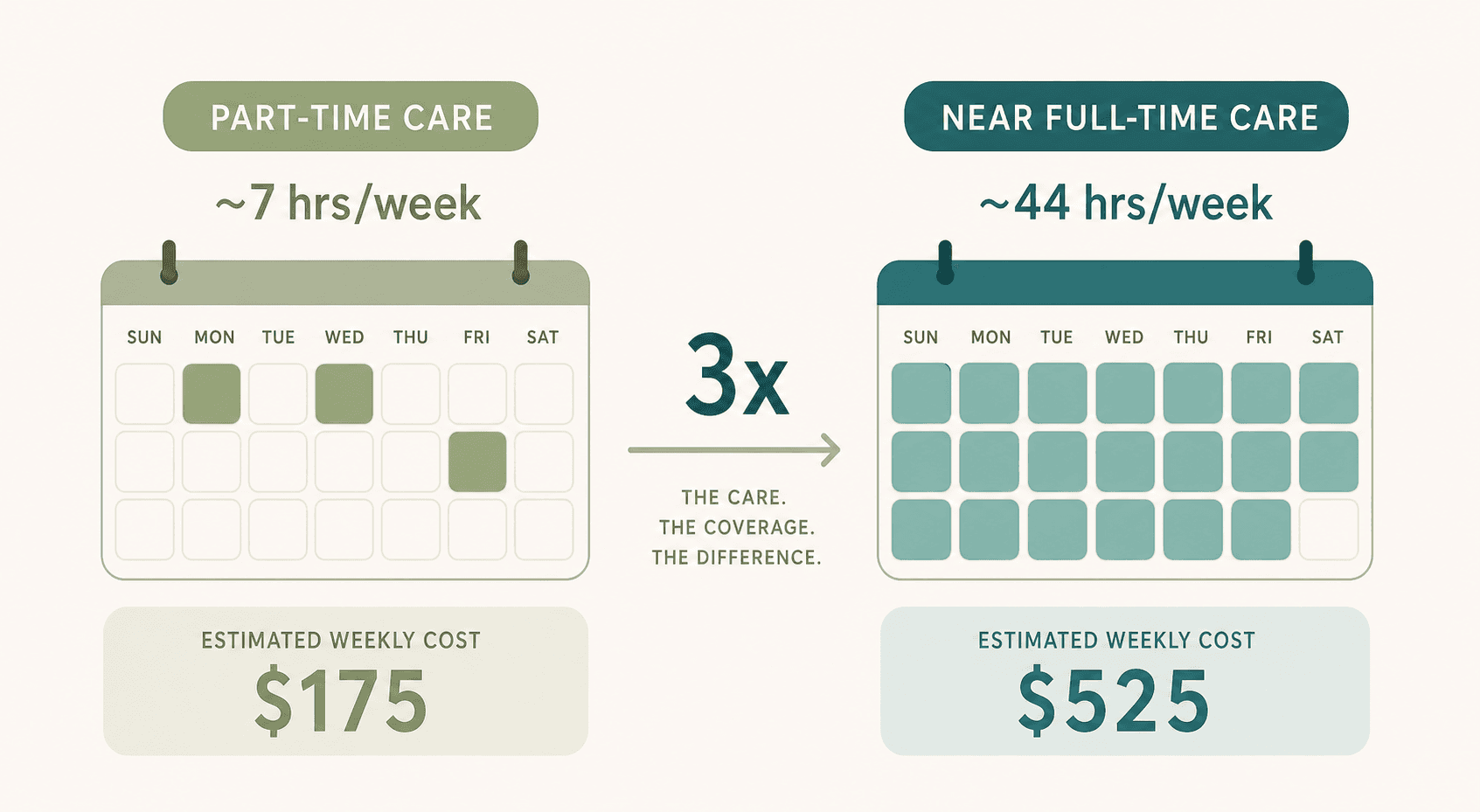

A side-by-side illustration comparing a part-time care schedule of 7 hours per week with a near-full-time schedule of 44 hours per week, showing the roughly 3x cost difference.
The difference between part-time and near-full-time care schedules creates a roughly 3-to-1 swing in monthly cost at the same hourly rate.

Full State-by-State Median Hourly Rates (2026)

The table below compiles median hourly rates for all 50 states and the District of Columbia from A Place for Mom's 2026 report and SeniorLiving.org's 2026 data. Where the two sources differ by more than $1, both figures are shown. These are median rates for non-medical in-home care — homemaker services and home health aide combined — not skilled nursing care.

Median hourly rates for non-medical in-home care by state, 2026. Sources: A Place for Mom 2026 Costs of Long-Term Care and Senior Living Report; SeniorLiving.org 2026 Home Care Costs data.
StateMedian Hourly RateStateMedian Hourly Rate
Alabama$27Montana$33
Alaska$36Nebraska$35
Arizona$33Nevada$33
Arkansas$27New Hampshire$35
California$35New Jersey$35
Colorado$36New Mexico$30
Connecticut$35New York$35
Delaware$30North Carolina$29
District of Columbia$35North Dakota$36
Florida$30Ohio$32
Georgia$29Oklahoma$28
Hawaii$35Oregon$37
Idaho$31Pennsylvania$33
Illinois$35Rhode Island$34
Indiana$32South Carolina$28
Iowa$33South Dakota$44
Kansas$32Tennessee$29
Kentucky$28Texas$28
Louisiana$23–$26Utah$33
Maine$30Vermont$34
Maryland$33Virginia$30
Massachusetts$37Washington$42
Michigan$32West Virginia$28–$29
Minnesota$41–$42Wisconsin$36
Mississippi$25Wyoming$33
Missouri$30

The range is striking. Mississippi and Louisiana sit at $23 to $26 per hour, while South Dakota ($44), Washington ($42), and Minnesota ($41–$42) are nearly double. The difference is not simply a cost-of-living adjustment — it reflects local labor market conditions, state minimum wage laws, the availability of home care workers, and regional differences in how care is delivered.

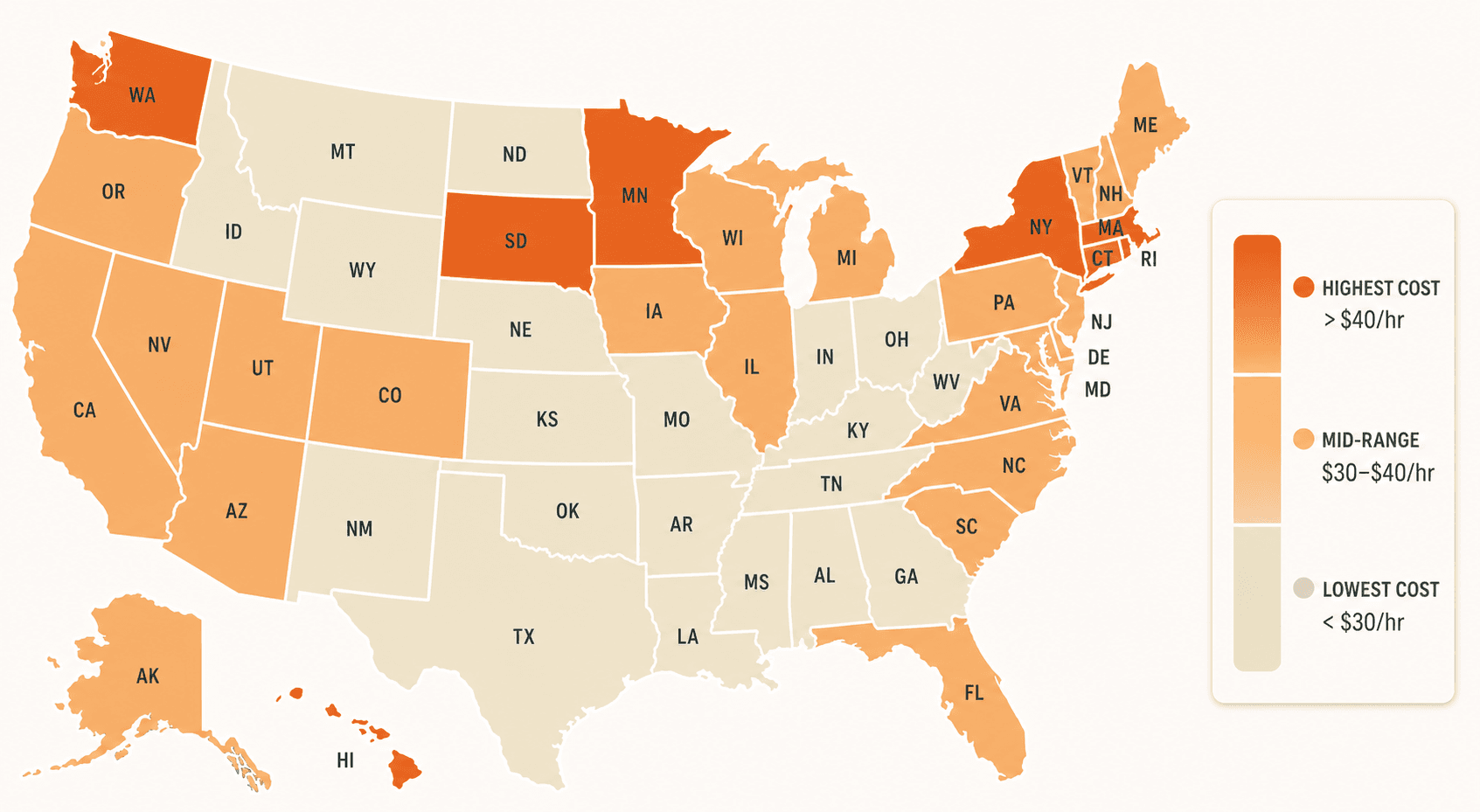

A color-coded map of the United States showing states shaded from dark orange (highest cost, above $40/hr) to soft beige (lowest cost, below $30/hr).
Geographic variation in median hourly home care rates across the United States, 2026. Darker states represent higher costs.

Agency vs. Private Hire: The 20–30% Premium and What It Buys

The rates above reflect what you would pay a home care agency. Hiring a private caregiver directly — someone you find through a referral, a local ad, or an online platform — typically costs 20 to 30% less. That difference can mean $7 to $10 per hour off the agency rate, which adds up to hundreds of dollars per month.

But the agency premium buys specific protections that many families find essential:

  • Background checks and credential verification: Agencies screen caregivers before sending them into your home.
  • Payroll and tax handling: The agency is the employer of record, which means you do not have to manage payroll taxes, workers' compensation, or unemployment insurance.
  • Backup coverage: If the regular caregiver calls in sick, the agency sends a replacement. With a private hire, you are the backup plan.
  • Liability and bonding: Agency caregivers are covered by the agency's insurance, protecting you if something is damaged or an accident occurs.

For many families, the 20–30% premium is worth the peace of mind, especially when care needs are complex or the parent lives alone. For others, especially those with a trusted referral or a family member who can supervise, private hire makes financial sense.

Annual Projections: $31,000 to $80,000+ Depending on Schedule

Annualizing the monthly costs gives a clearer picture of the long-term financial commitment. Using the $34 per hour national median, here is what a year of care costs at different weekly schedules:

Annual cost projections for in-home care at different weekly schedules. Monthly costs based on $34/hr (A Place for Mom). CareScout's $35/hr rate yields $80,080 annually at 44 hrs/week × 52 weeks.
Weekly HoursMonthly CostAnnual Cost
7 hours$1,031$12,372
15 hours$2,208$26,496
30 hours$4,416$52,992
44 hours$6,478$77,736
44 hours (CareScout $35/hr)$6,731$80,080

The annual range — from roughly $12,000 for a few hours of weekly companionship to over $80,000 for near-full-time care — explains why most families use a combination of paid care and family-provided care. Even at the 30-hour-per-week level, $53,000 per year is a significant expense that requires planning.

For families looking to reduce costs, our complete guide to affordable senior care covers assistance programs, money-saving strategies, and ways to stretch a care budget without sacrificing quality.

How In-Home Care Compares to Assisted Living and Nursing Homes

Families often assume that home care is cheaper than a facility. That is true at lower care hours, but the math flips as needs increase. Here is how the monthly costs compare using 2026 data:

Monthly cost comparison across care settings. In-home care at 44 hrs/week from A Place for Mom ($34/hr). Assisted living and nursing home costs from CareScout 2025 Cost of Care Survey and SeniorLiving.org 2026 data.
Care SettingMonthly Cost (2026 Median)
In-home care (44 hrs/week)$6,478
Assisted living$6,200
Nursing home (semi-private room)$9,581
Nursing home (private room)$10,798

At 44 hours per week, in-home care costs roughly the same as assisted living — about $6,200 to $6,500 per month. But home care becomes more expensive than a nursing home when care needs exceed 40 to 50 hours per week, because you are paying for labor on top of your parent's existing housing costs (mortgage or rent, utilities, groceries, home maintenance). Nursing home costs are all-inclusive: housing, meals, 24-hour supervision, and skilled nursing are bundled into the monthly rate.

Using This Data to Build Your Family's Care Budget

The numbers in this guide are a starting point, not a final answer. Here is a practical framework for turning them into a budget that reflects your family's actual situation:

  1. Start with your state's median hourly rate from the table above. If your state has a range (e.g., Louisiana $23–$26), use the higher end for a conservative estimate.
  2. Estimate the weekly hours your parent needs. Be honest about what family members can provide and what must be hired out. Most families underestimate the hours needed in the first month.
  3. Multiply: hourly rate × weekly hours × 4.33 (average weeks per month) to get a monthly estimate. Then multiply by 12 for an annual projection.
  4. Add 20–30% if you plan to use an agency. Subtract 20–30% if you plan to hire privately, but add the cost of your time for payroll, scheduling, and backup coverage.
  5. Factor in your parent's existing housing costs. Home care adds to those costs; facility care replaces them.

Once you have a realistic budget, the next question is how to pay for it. Our guide to payment options for elderly home care covers Medicare, Medicaid HCBS waivers, VA benefits, long-term care insurance, and other funding sources that can make in-home care affordable.
